A bridge may be structurally sound, yet drivers can still experience a noticeable bump at its entrance. In many cases, the problem does not originate in the main bridge structure. It develops in the transition between the flexible roadway embankment and the relatively rigid bridge abutment. This is why Bridge Approach Design deserves the same engineering attention as the bridge deck, foundation, and pavement.
A properly designed bridge approach provides a smooth, durable, and safe transition from roadway pavement to the bridge structure. It must accommodate differences in stiffness, control differential settlement, manage drainage, transfer traffic loads, and protect the abutment and surrounding embankment.
This guide explains the fundamental principles of bridge approach design, including approach slabs, transition zones, embankment construction, settlement assessment, structural design, drainage, reinforcement, construction practices, common failures, inspection, and practical recommendations for engineers and contractors. It also discusses how IRC and AASHTO-based approaches can be used as a technical framework while recognizing that project-specific requirements and governing specifications must always control.

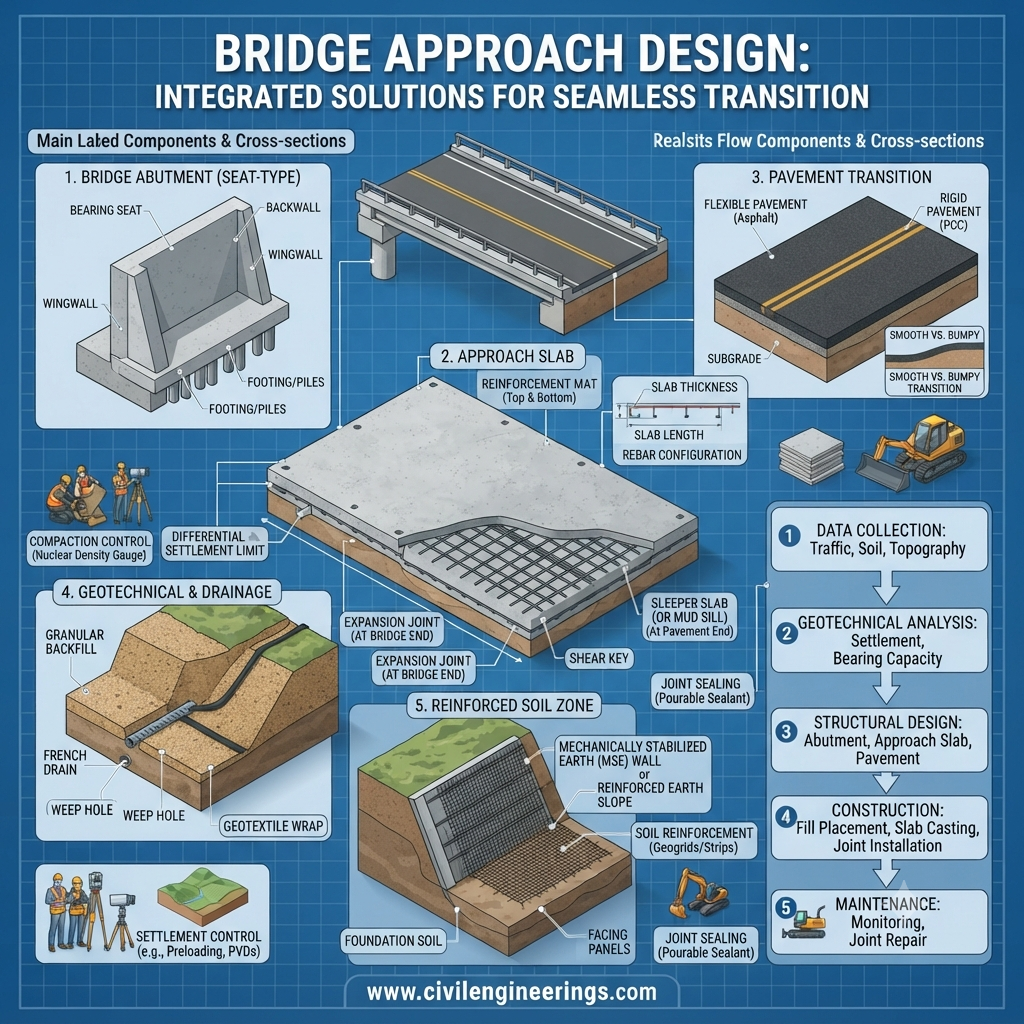

What Is Bridge Approach Design?
Bridge approach design is the engineering process used to create a safe and serviceable transition between the highway pavement and a bridge structure.
The approach normally includes the roadway embankment, pavement layers, approach slab where specified, sleeper or transition support, abutment backfill, drainage provisions, retaining or wing walls, reinforcement, and associated safety features.
The fundamental challenge is simple: the bridge and the roadway do not behave in the same way.
A bridge is supported by foundations and structural members with relatively controlled deformation. The road approach is supported by soil, which can compress, consolidate, deform, erode, or lose stiffness.
Why the Bridge-to-Road Transition Matters
The transition zone is exposed to repeated wheel loading and environmental effects. If settlement develops near the abutment, vehicles encounter a sudden change in elevation.
This can cause:
- Impact loading from heavy vehicles
- Poor riding quality
- Pavement cracking
- Approach slab distress
- Water infiltration
- Damage to expansion joints
- Backfill erosion
- Increased maintenance requirements
- Progressive deterioration of the transition
IRC’s bridge inspection guidance specifically identifies the approach slab as a transition between roadway pavement and the bridge and notes that settlement near the abutment can create an uneven transition and increased vehicle impact. (IRINN)
Main Objectives of Approach Design
A successful bridge approach should:
- Provide a smooth riding surface.
- Minimize differential settlement.
- Transfer traffic loads effectively.
- Protect the abutment and backfill.
- Provide reliable drainage.
- Accommodate bridge movement.
- Maintain pavement performance.
- Resist erosion and environmental effects.
- Allow practical construction and inspection.
- Reduce long-term maintenance.
Main Components of a Bridge Approach
Bridge approaches vary according to bridge type, roadway classification, soil conditions, climate, and governing standards. However, several components occur repeatedly in highway projects.
Approach Slab
An approach slab is a reinforced concrete slab placed between the bridge abutment and roadway pavement.
Its primary purpose is to bridge a zone where soil settlement may occur. Rather than allowing the pavement to follow localized settlement immediately behind the abutment, the slab provides structural continuity across the vulnerable area.
FHWA design examples treat the approach slab as a structural element and commonly analyze it as a one-way slab spanning between the abutment and sleeper slab where soil support is conservatively neglected. (Federal Highway Administration)
Abutment
The abutment supports the bridge superstructure and retains the approach embankment.
Its design must consider:
- Vertical bridge reactions
- Earth pressure
- Surcharge
- Braking and traction forces
- Seismic effects where applicable
- Temperature and movement effects
- Foundation capacity
- Settlement
- Drainage
The approach and abutment should therefore be designed as an integrated system rather than as completely independent components.
Approach Embankment
The approach embankment provides the roadway platform leading to the bridge.
Its performance depends heavily on:
- Soil type
- Fill quality
- Moisture condition
- Compaction
- Embankment geometry
- Groundwater
- Foundation soil
- Construction sequence
Even a well-designed concrete approach slab cannot compensate indefinitely for poorly constructed embankment fill.
Sleeper Slab
A sleeper slab or transition support may be provided at the roadway end of the approach slab.
It creates a defined support point and helps transfer the slab load into the embankment. Its location should be coordinated with the expected movement zone behind the abutment.
Drainage and Filter Layers
Drainage is one of the most important but frequently underestimated parts of approach design.
Water can soften backfill, increase pore pressure, reduce soil strength, transport fines, and create voids below pavement or approach slabs.
Typical provisions may include:
- Free-draining granular backfill
- Drainage blankets
- Perforated collector pipes
- Filter layers
- Geotextiles
- Weep holes where appropriate
- Positive surface drainage
- Sealed joints and pavement interfaces
Geotechnical Considerations in Bridge Approach Design
The greatest long-term challenge is often not concrete strength. It is ground movement.
Differential Settlement
Differential settlement occurs when two adjacent parts of the roadway or structure settle by different amounts.
For a simplified evaluation, angular distortion can be expressed as:
where:
- = angular distortion
- = differential settlement
- = distance over which settlement occurs
A relatively small vertical settlement can become a significant serviceability problem when it occurs over a short distance.
FHWA notes that excessive foundation and engineered-fill movement can affect ride quality, drainage, safety, and structural performance. Serviceability evaluation therefore considers tolerable movement rather than strength alone. (Federal Highway Administration)
Sources of Settlement
Settlement behind a bridge abutment may result from several mechanisms.
Embankment Compression
New fill produces additional vertical stress in the underlying soil. Compressible layers may gradually deform.
Consolidation of Soft Clay
Soft saturated clay can undergo consolidation as excess pore-water pressure dissipates.
Inadequate Compaction
Loose fill placed behind an abutment may densify under traffic.
Construction Difficulty Near the Abutment
The restricted space behind an abutment can make compaction difficult. This is one reason the approach region requires careful construction control.
Erosion and Loss of Support
Poor drainage may wash fines out of the backfill, leaving voids beneath the pavement or approach slab.
Settlement Control Measures
Bridge approach design should address settlement before construction rather than relying on future pavement repairs.
Improve the Foundation Soil
Depending on the site, engineers may consider:
- Removal and replacement
- Preloading
- Vertical drains
- Soil stabilization
- Geosynthetic reinforcement
- Lightweight fill
- Deep foundations
- Ground improvement
The selected solution depends on soil properties, settlement magnitude, construction period, groundwater, and project economics.
Use Controlled Approach Fill
Backfill behind the abutment should meet the project specification for material quality, moisture, placement thickness, and compaction.
Construction should avoid placing thick uncontrolled layers that cannot achieve the required density.
Stage Construction Where Necessary
On compressible ground, staged embankment construction can allow some settlement to occur before final pavement and bridge connection works.
Instrumentation such as settlement plates or piezometers may be appropriate for major projects.
Structural Design of the Approach Slab
An approach slab must be designed for the loads and support conditions specified by the governing bridge standard.
Design Loads
Depending on the adopted code, design considerations may include:
- Self-weight
- Wearing surface
- Vehicular live load
- Dynamic effects or impact provisions
- Earth-related effects
- Temperature
- Shrinkage
- Differential movement
- Construction loads
The governing load combinations should be taken directly from the current project code rather than copied from an older design example.
FHWA’s bridge design examples include dedicated approach slab design steps within the substructure design process, illustrating that approach slabs are treated as engineered structural components rather than merely pavement extensions. (Federal Highway Administration)
Simplified Flexural Concept
For preliminary understanding, if an approach slab behaves approximately as a simply supported one-way member under uniform load:
and:
where:
- = maximum bending moment
- = maximum shear
- = design load per unit width
- = effective span
These equations are useful for explaining the structural behavior, but they should not replace the applicable code procedure.
Actual design may require consideration of continuity, support conditions, wheel-load distribution, soil interaction, joint details, construction sequence, and applicable load factors.
Reinforcement Detailing
Reinforcement should be designed for the calculated flexural and serviceability demands.
Particular attention should be given to:
- Main longitudinal reinforcement
- Distribution reinforcement
- Crack control
- Anchorage
- Development length
- Joint detailing
- Concrete cover
- Reinforcement congestion
- Compatibility with abutment reinforcement
Poor detailing can create a weak transition even when the calculated steel area appears adequate.
Bridge Approach Slab Length and Geometry
There is no single universal approach slab length suitable for every bridge.
The appropriate length depends on:
- Abutment geometry
- Embankment height
- Soil properties
- Expected settlement
- Pavement type
- Bridge movement
- Traffic loading
- Local authority requirements
- Structural design assumptions
FHWA’s design guidance notes that approach slab length can be related to the depth of the integral abutment and that the sleeper slab should be positioned beyond the zone significantly affected by abutment movement and approach fill behavior. (Federal Highway Administration)
Longitudinal Profile
The road profile should provide a gradual transition.
Abrupt changes in grade should be avoided because they can increase vehicle impact and produce uncomfortable driving conditions.
The final profile should also maintain adequate drainage toward the intended drainage system.
Cross Slope
The approach slab and pavement should maintain the required crossfall or cross slope.
Poorly controlled cross slope can create:
- Ponding
- Hydroplaning risk
- Edge deterioration
- Water infiltration
- Reduced pavement life
Backfill and Compaction Requirements
The quality of backfill is fundamental to bridge approach performance.
Suitable Backfill Material
Depending on the project specification, selected granular material may be preferred because it can provide:
- Good drainage
- Better compaction
- Lower compressibility
- More predictable behavior
- Reduced sensitivity to moisture
The material should still comply with the governing specification rather than being selected solely because it is granular.
Compaction Procedure
Compaction should proceed in controlled layers.
A typical construction control sequence includes:
- Prepare the foundation.
- Install drainage provisions.
- Place approved fill.
- Spread the fill in controlled lifts.
- Adjust moisture where required.
- Compact using suitable equipment.
- Verify density.
- Repeat until the required elevation is achieved.
Heavy compaction equipment should be used carefully near retaining walls and abutments to avoid excessive lateral pressures or structural damage.
Drainage Design for Bridge Approaches
Water management is essential to long-term bridge approach performance.
Surface Drainage
The pavement should direct water toward designed drainage facilities.
Water should not be allowed to collect at the bridge end.
Subsurface Drainage
Where required, subsurface drainage can intercept water within the backfill.
A typical drainage arrangement may include a perforated pipe surrounded by properly graded filter material.
The drainage system must have a positive outlet. A drain that collects water but has no reliable discharge path can become a concealed source of saturation.
Waterproofing and Joint Control
Water can enter through cracks, joints, pavement interfaces, and poorly sealed details.
Therefore, joint design should be coordinated with:
- Abutment movement
- Expansion joint requirements
- Approach slab movement
- Pavement type
- Drainage
- Waterproofing
Integral and Conventional Abutment Approaches
Approach details differ depending on the bridge-abutment system.
Integral Abutments
Integral bridges connect the superstructure and abutment in a manner that allows controlled longitudinal movement through foundation flexibility and structural deformation.
Approach slabs are commonly used to reduce the effects of settlement and movement behind the abutment.
FHWA notes that integral-abutment approaches can experience pavement settlement from fill movement and seasonal abutment movements, and that approach slabs help bridge the affected zone. (Federal Highway Administration)
Conventional Expansion-Joint Bridges
Conventional bridges may use bearings and expansion joints.
The approach must therefore accommodate movement at the bridge end while preventing excessive water and debris intrusion.
Expansion-joint detailing becomes especially important because failures at the joint can accelerate deterioration of the bridge deck, abutment, and approach pavement.
Construction Sequence for Bridge Approaches
A well-developed construction sequence can prevent many approach problems.
Recommended Sequence
A typical sequence is:
- Complete foundation and abutment construction.
- Install required drainage systems.
- Complete waterproofing and protective treatments.
- Place approved backfill in controlled lifts.
- Compact each layer.
- Construct the sleeper support where specified.
- Prepare approach slab formwork.
- Install reinforcement and joints.
- Place and cure concrete.
- Complete pavement transition.
- Construct shoulders and safety features.
- Inspect the finished profile and drainage.
The actual sequence must follow the project’s drawings, specifications, temporary works requirements, and structural engineer’s instructions.
Quality Control During Construction
Important inspection points include:
- Backfill material approval
- Lift thickness
- Moisture content
- Field density
- Reinforcement size and spacing
- Concrete strength
- Concrete cover
- Joint installation
- Drainage outlet
- Surface levels
- Cross slope
- Approach profile
A few additional inspection hours during construction can prevent expensive corrective work later.
Common Bridge Approach Problems
Several recurring failures can be traced to inadequate coordination between geotechnical, structural, pavement, and drainage design.
The Bump at the End of the Bridge
This is one of the most recognizable approach problems.
It may result from:
- Differential settlement
- Poor compaction
- Erosion
- Inadequate drainage
- Approach slab movement
- Abutment movement
The solution should address the underlying mechanism rather than simply placing additional asphalt over the depression.
Cracking of the Approach Slab
Cracks may develop because of:
- Excessive bending
- Shrinkage
- Thermal movement
- Poor reinforcement detailing
- Differential support
- Construction defects
Crack pattern, width, location, and progression should be assessed before selecting a repair method.
Void Formation
Loss of backfill beneath an approach slab can create voids.
Possible causes include:
- Water erosion
- Poorly compacted material
- Inadequate drainage
- Joint leakage
- Settlement
Ground-penetrating radar, coring, level surveys, or other investigation methods may be used where appropriate.
Inspection and Maintenance of Bridge Approaches
Bridge approach inspection should not stop at the bridge deck.
Inspectors should examine:
- Pavement profile
- Approach slab cracks
- Expansion joints
- Drainage outlets
- Shoulder condition
- Abutment backfill
- Erosion
- Settlement
- Surface water ponding
- Guardrail and barrier transitions
Measuring Settlement
A simple level survey can identify changes in elevation.
For larger projects, repeated surveys can establish a settlement trend:
where:
- = settlement at time
- = reference elevation
- = measured elevation at time
The objective is not simply to identify whether settlement exists. Engineers should determine whether it is stabilizing, accelerating, or occurring unevenly.
IRC, AASHTO and ICE Considerations
Bridge approach design should always follow the governing authority and current edition of the applicable standards.
IRC
For projects in India and jurisdictions adopting IRC practice, designers should consult the current applicable IRC documents for bridge loading, bridge design, foundations, concrete, expansion joints, road geometry, construction, and maintenance.
IRC has continued revising its bridge and highway standards. For example, IRC lists IRC:5-2024 for general features of road-bridge design, IRC:78-2024 for foundations and substructures, and IRC:SP:35-2024 for bridge management, inventory, inspection, and maintenance. (IRINN)
AASHTO
AASHTO LRFD provides the framework commonly used in the United States and in many international bridge design practices influenced by U.S. standards.
Designers should consult the current edition for:
- Load combinations
- Limit states
- Structural resistance
- Reinforced concrete
- Abutments
- Foundations
- Approach slabs
- Serviceability
- Movement
- Detailing
FHWA’s published bridge examples demonstrate the practical application of AASHTO LRFD provisions to abutments, foundations, and approach slabs. (Federal Highway Administration)
ICE
ICE publications and UK bridge engineering practice can provide valuable technical context, particularly for geotechnical behavior, structural assessment, earthworks, durability, and infrastructure management.
However, an ICE publication should not automatically be substituted for the governing highway authority’s bridge standard. The contract documents and adopted national standards remain controlling.
Practical Recommendations for Civil Engineering Students
Students should understand bridge approaches as a soil-structure-pavement interaction problem, not merely a concrete slab problem.
Focus on:
- Differential settlement
- Consolidation
- Compaction
- Earth pressure
- Reinforced concrete slab behavior
- Drainage
- Pavement transitions
- Serviceability
Practice drawing a bridge approach cross-section and identifying every component from the roadway pavement to the abutment.
Practical Recommendations for Highway and Bridge Engineers
Engineers should coordinate the geotechnical, structural, pavement, and drainage designs early.
Before finalizing the design, verify:
- Ground investigation data
- Settlement estimates
- Backfill properties
- Approach slab assumptions
- Abutment movement
- Drainage
- Joint details
- Pavement transition
- Construction sequence
- Inspection requirements
Do not select approach slab dimensions solely from a previous project. Similar-looking bridges can have very different ground conditions.
Practical Recommendations for Contractors
Contractors should treat the approach zone as a high-control area.
Pay particular attention to:
- Approved fill material
- Lift thickness
- Compaction
- Moisture
- Drainage installation
- Reinforcement placement
- Concrete curing
- Finished elevations
- Joint installation
The most expensive approach problems often begin with seemingly minor construction deviations.
Frequently Asked Questions About Bridge Approach Design
What is the purpose of an approach slab?
An approach slab provides a structural transition between the roadway pavement and bridge abutment. It helps bridge areas where settlement behind the abutment could otherwise produce an abrupt pavement depression.
Why do bridges develop a bump at the approach?
The bump is commonly associated with differential settlement between the bridge structure and adjacent roadway embankment. Poor compaction, compressible soils, drainage problems, and erosion can contribute.
Is an approach slab required for every bridge?
Not necessarily. Requirements depend on bridge type, roadway conditions, soil behavior, governing standards, owner requirements, and the selected transition system.
How is approach slab length determined?
Approach slab length depends on structural behavior, expected ground movement, abutment geometry, bridge movement, soil conditions, pavement configuration, and applicable design standards. It should be established through engineering analysis rather than an arbitrary standard dimension.
What type of soil is suitable for bridge approach backfill?
Suitable material is normally selected based on the project specification and should provide adequate strength, compaction, stability, and drainage. Well-graded granular materials are frequently used, but the governing specification controls.
How can differential settlement be reduced?
Possible measures include improved compaction, removal and replacement of poor soil, staged construction, preloading, drainage improvement, ground improvement, lightweight fill, and structural transition slabs.
What causes approach slab cracking?
Cracking can result from flexural demand, shrinkage, thermal movement, differential settlement, inadequate reinforcement, poor detailing, or construction deficiencies.
Why is drainage important behind bridge abutments?
Drainage prevents excessive water accumulation in the backfill. Poor drainage can increase pore pressure, reduce soil performance, promote erosion, and contribute to settlement or void formation.
Should the soil beneath an approach slab be considered structurally?
The appropriate modeling assumption depends on the design method and governing standard. Some conservative approaches design the slab to span between defined supports while neglecting long-term soil support because settlement may cause loss of contact.
Which standards should be used for bridge approach design?
Use the current standard adopted by the project authority. Depending on the jurisdiction, this may include IRC, AASHTO LRFD, national bridge codes, highway specifications, and owner-specific standards. Supporting guidance from organizations such as FHWA and ICE can supplement, but not override, the governing requirements.
Conclusion
Effective Bridge Approach Design is fundamentally about controlling the transition between a rigid bridge structure and a deformable roadway system. The approach slab is important, but it is only one part of the solution. Long-term performance depends on the interaction of the abutment, foundation, backfill, embankment, pavement, drainage, joints, and construction quality.
The most reliable designs begin with a realistic understanding of ground conditions and expected settlement. Structural calculations must then be coordinated with geotechnical and pavement requirements. Proper backfill selection, controlled compaction, effective drainage, appropriate reinforcement, movement accommodation, and careful construction inspection all contribute to a smoother and more durable bridge approach.
A successful bridge approach is therefore not simply a concrete slab at the end of a bridge. It is an engineered transition system designed to provide safety, comfort, durability, and predictable performance throughout the bridge’s service life.
